Abington Environmental Infrastructure Improvement Project

The purpose of the project is to stabilize, naturalize, and improve ecosystem function along Sandy Run Creek at Roychester Park and Grove Park in Abington Township, Pennsylvania. Specific objectives are to enhance and restore aquatic, wetland, and riparian habitat; improve infiltration of flood waters; stabilize stream banks and reduce erosion; control invasive species; and reconnect floodplains.

In Roychester Park, the banks in the above ground sections of the creek are currently severely eroded and disconnected from the surrounding floodplain. Furthermore, invasive species and other factors reduce the quality of the habitat. In Grove Park, the main section of the creek is channelized with concrete, which reduces the aquatic habitat value and increases water velocities during storms.

Construction within Roychester Park and Grove Park will be similar, but include different features in each park.

In Roychester Park, the Army Corps of Engineers and it's contractor will:

  • Bank Stabilization: Regrade, stabilize, and plant stream banks to reduce erosion and sedimentation in this stretch of Sandy Run.
  • Culvert Replacement: Replace two culverts with pre-fabricated steel footbridges.
  • Sanitary Sewer Relocation: Replace and relocate approximately 760 feet of sewer line and manholes that have been exposed due to ongoing erosion.
  • Riparian Enhancement: Provide 20 to 25 feet of continuous riparian buffers along the creek, to the extent possible.
  • Upland Native Planting: Plant a native wildflower meadow near Corinthian Avenue on a hill that has little recreational value.

In Grove Park, the Army Corps of Engineers and it's contractor will:

  • Stream Naturalization and Stabilization: Remove existing gabion baskets, regrade banks with stream benches to better connect the main channel with the forested riparian buffer. Remove 370 linear feet of concrete channel bottom and replaced with stream substrate of riprap choked with smaller stone. Provide additional stream stabilization using large woody debris.
  • Riparian Enhancement: Plant riparian area from the top of bank to a width of approximately 50 feet on both sides of the stream with native tree, shrub, and herbaceous species. Plant upland areas with native trees, shrubs, and herbaceous plants to expand the riparian buffer into open high ground and connect the riparian buffer to the existing adjacent forested floodplain.
  • Forested Floodplain Enhancement: Excavate a tributary channel in a low-lying area of the forested floodplain. Fill the stormwater channel at the east end of the park and redirect the storm water outfall into the excavated channel to utilize the filtrating and storage capacity of the forested floodplain and wetlands in the park. Excavate small areas in the forested floodplain to enhance wetland functions. Remove multiflora rose from this section of the park.

Generally speaking, construction will involve the use of excavators, dump trucks, and other heavy equipment. Materials, including rip rap, pre-fabricated foot-bridges, and sewer pipeline will be trucked to the site. Excess soil and stones will be removed from the site.  Access will be fenced off for safety purposes. Construction is expected to take a total of one year for both parks.

The U.S. Army Corps of Engineers (USACE) is preparing the Invitation for Bid for the construction contract. Once a contract is awarded, USACE then works with the selected contractor on a schedule and other details associated with construction.

The U.S. Army Corps of Engineers is managing the overall project. A contractor (yet to be determined) will be responsible for physical construction. Abington Township is the non-federal sponsor for the project. Construction is cost shared between the federal government (65%) and the Township (35%).

  • Information specific to Grove Park will be posted here leading up to and during construction

  • Information specific to Roychester Park will be posted here leading up to and during construction of the project

Currently, the U.S. Army Corps of Engineers estimates construction may start in Fall of 2023 and end in Fall of 2024.

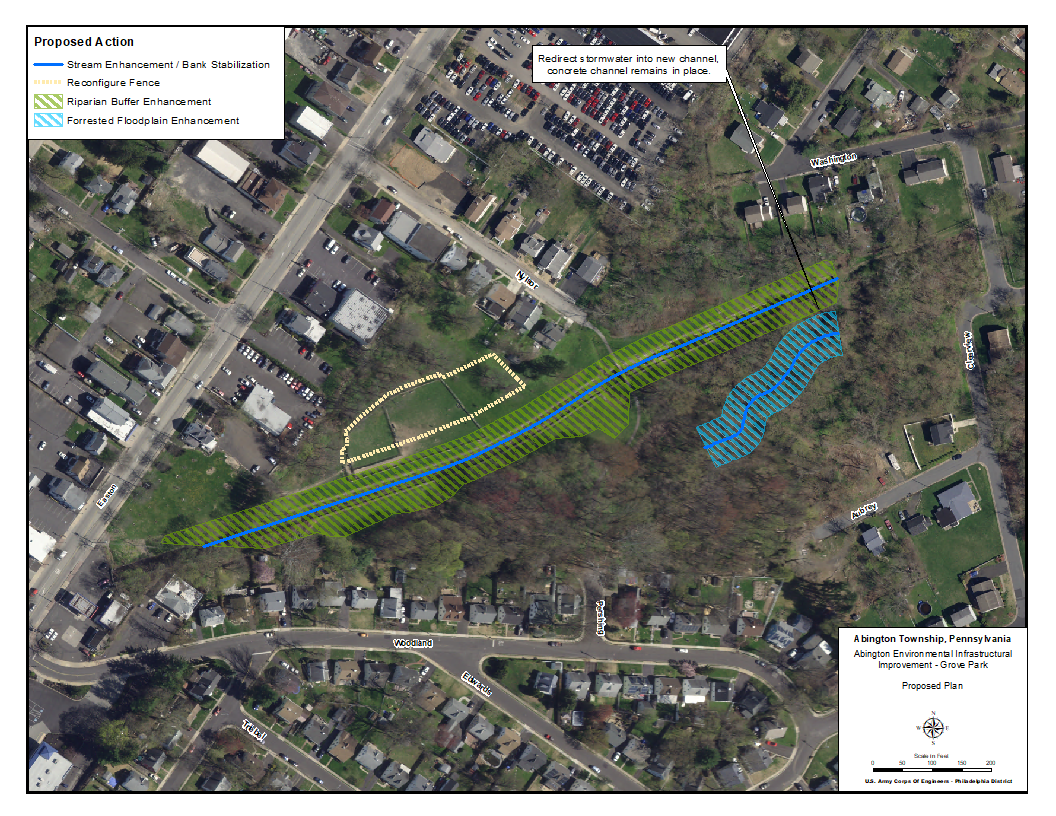

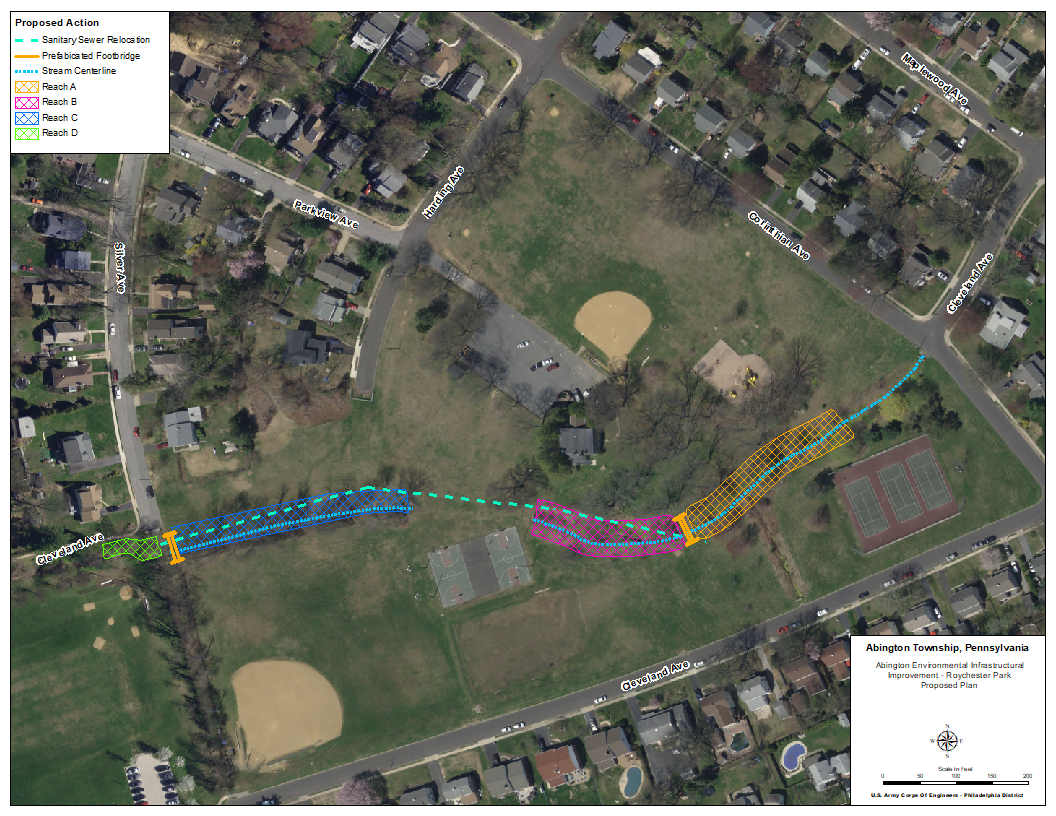

Maps of Proposed Action
